A finished container home may look compact sitting on a foundation, but moving one is a heavy-haul project. Once a converted container leaves private property and enters a public roadway, its width, height, weight and configuration determine what equipment can carry it and which permits may be required.
That distinction matters if you're buying a prefab container home in another state, relocating an existing structure or moving a modular assembly to new property. Shipping container homes isn't the same job as hauling an empty freight container. Windows, doors, insulation, plumbing, electrical equipment and interior finishes all need protection, while the carrier must account for the dimensions and weight of the completed structure.

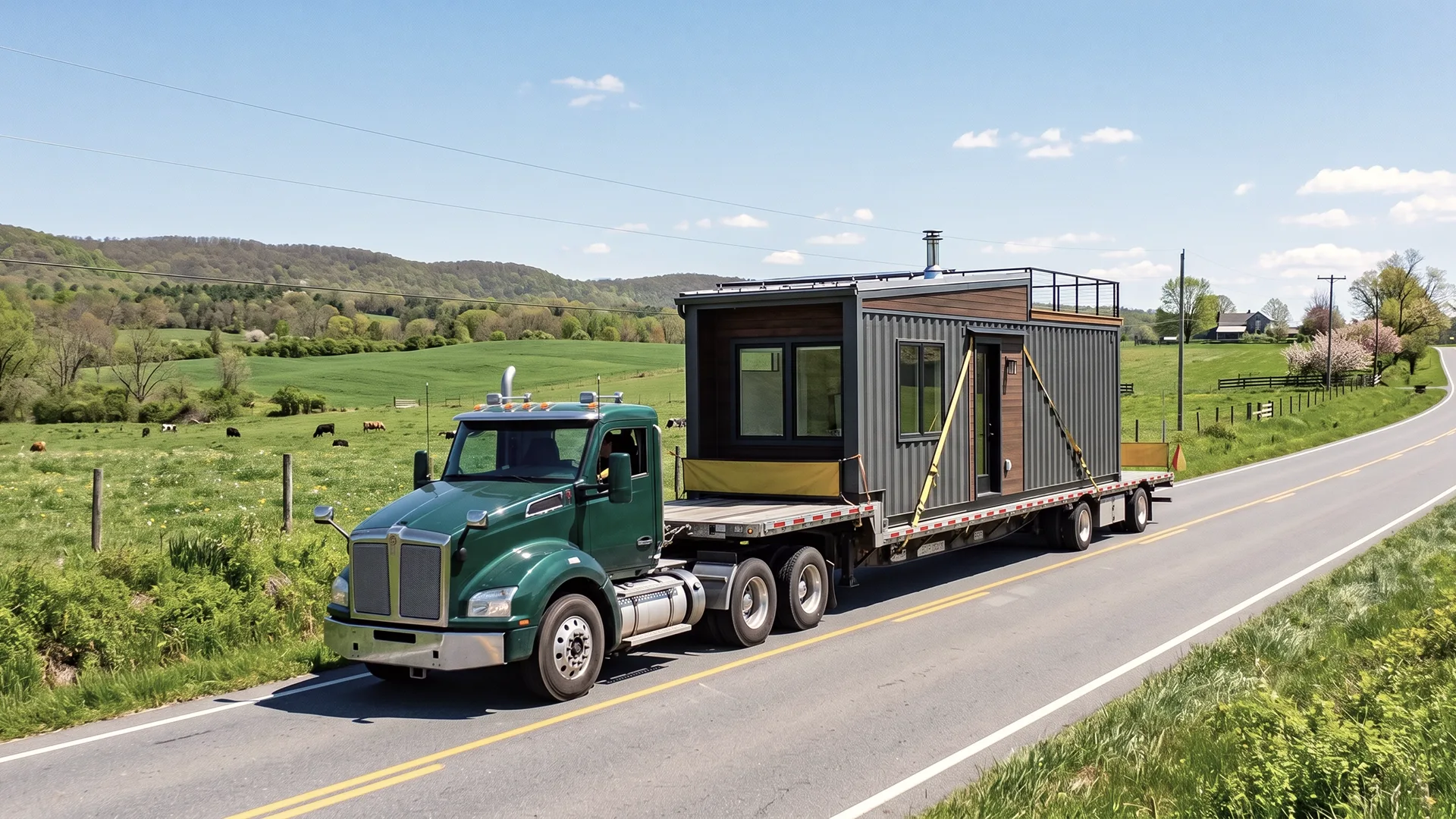

The move should be planned before the home is disconnected from utilities or a crane arrives. Route restrictions, permits, loading equipment and site access can determine whether the move is relatively straightforward or a complicated oversized-load operation.
Why Container Home Shipping Requires Careful Planning
A standard ISO freight container is already about 8 feet wide. Once it's converted into a home, exterior additions such as siding, roof structures, utility connections or other modifications may increase its dimensions.
Federal Highway Administration (FHWA) rules generally establish a 102-inch (8-foot-6-inch) maximum commercial vehicle width on the National Network. There is no single federal vehicle-height limit. States establish their own height restrictions, which commonly fall between 13 feet 6 inches and 14 feet 6 inches.
Those measurements apply to the loaded vehicle, not simply the container itself. Put a tall container home on a trailer and its total transport height can become the controlling factor.
Before arranging container home shipping, document:
- Exterior length, width and height
- Actual or reliably calculated structure weight
- Roof overhangs, decks or other exterior additions
- Foundation and attachment method
- Utility connections that must be disconnected
- Pickup and delivery site access
- Crane or lifting requirements at both locations
- Destination foundation readiness
If you're coordinating the container-home move with a broader household relocation, Nexus' moving cost estimator can help you start organizing the other moving expenses around it.
What Permits Are Needed to Move a Container Home?
There isn't one nationwide oversized-load permit that covers an interstate container-home move. The FHWA specifically states that the federal government does not issue oversize or overweight permits. Those permits are issued by individual states.
That makes interstate planning more complicated. A load traveling through four states may have to satisfy four sets of permit requirements.
The FHWA's State oversize and overweight permit information provides permit information and contacts for individual states. That includes when you want to ship container to home.
Depending on the structure and route, a move can involve:
- Oversize or overwidth permits
- Overheight authorization
- Overweight permits
- Approved travel routes
- Restricted travel hours or days
- Escort or pilot vehicles
- Warning signs, flags and lighting
- Additional local permits for roads outside the state highway system
Don't assume that receiving approval from the origin state clears the structure all the way to its destination. Permit requirements need to be checked for every state and, where applicable, local jurisdiction along the route.

Choosing the Right Trailer and Loading Method
The trailer depends on more than whether the structure started life as a 20- or 40-foot container. Finished dimensions, weight, ground clearance and loading conditions all matter.
Container Home Transport Requirements
Container Dimensions |
Required Trailer Type |
Permit Classification |
Loading Method |
|---|---|---|---|
Standard Twenty-Foot Container |
Flatbed or suitable container/heavy-haul trailer |
Standard or oversize depending on finished dimensions and loaded height |
Crane, side loader or appropriate lifting equipment |
High Cube Forty-Foot Container |
Flatbed, step-deck or lower-profile heavy-haul trailer as required |
Often requires careful height and route evaluation; oversize permits may apply |

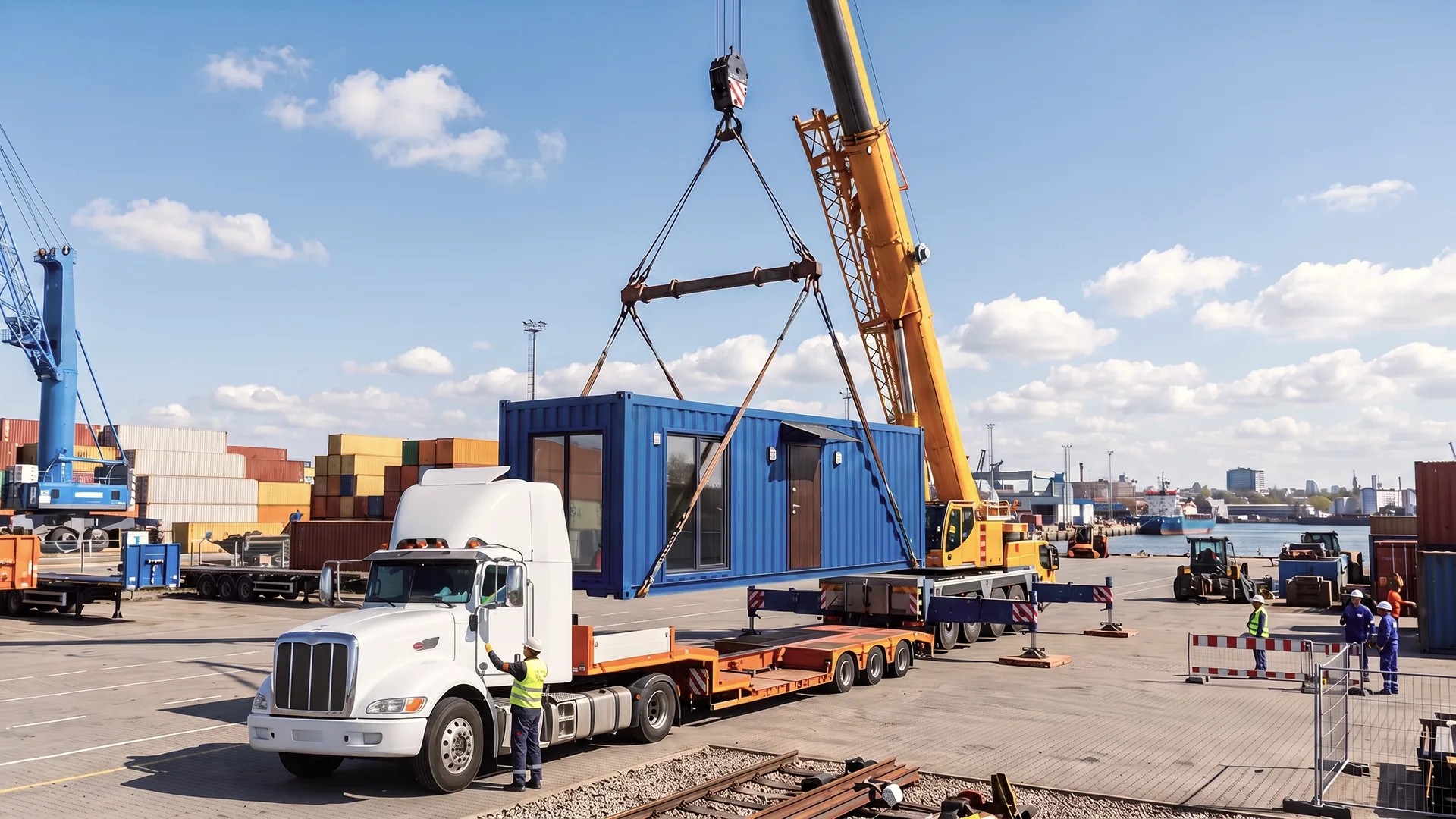

Crane or appropriate container lifting equipment |
Multi Container Modular Assembly |
Specialized heavy-haul trailer selected for dimensions and weight |
Oversize/overweight permits likely; requirements vary by state and configuration |
Heavy crane or engineered lifting plan |
This table is a planning guide, not a substitute for a carrier's load assessment. A high-cube container is 9 feet 6 inches tall before it's placed on a trailer. Roof additions or other modifications can make route clearance even more important.
A multi-container residence creates another decision. Sometimes the structure was designed to separate into transportable modules. In other cases, dismantling it would damage the building or require substantial reconstruction. The carrier and appropriate structural professionals need to determine what can safely be transported and how.
How Much Does It Cost to Transport a Shipping Container Home?
There's no meaningful national flat rate for moving a completed container home. Pricing depends heavily on the structure, dimensions, weight, equipment requirements and route.
The transportation quote can be affected by:
- Distance
- Finished dimensions and weight
- Required trailer configuration
- Number of states crossed
- Oversize and overweight permit fees
- Pilot or escort vehicle requirements
- Route surveys for tall or unusually large loads
- Crane service at origin and destination
- Accessibility of both properties
- Structure preparation
- Fuel costs and carrier availability
A basic container move and a finished home move can therefore have radically different costs. Current published commercial examples for ordinary 20-foot container transportation show individual routes ranging into several thousand dollars before accounting for the additional complications of moving a completed residence.
For that reason, the useful question isn't "What does it cost per mile?" It's "What equipment and services will this particular structure require?"
Use Estimate Moving Cost to plan the broader relocation budget, then obtain a shipment-specific assessment of the container structure itself.
Preparing a Shipping Container Home for Transport
A container may have been engineered to withstand demanding freight service, but the residential components added later weren't necessarily designed to experience highway vibration and movement.
Before pickup, work through the structure systematically.

Outside the Home
Remove or secure anything that changes the transport envelope or could move in transit, including:
- Awnings and removable overhangs
- Exterior furniture and decorations
- Satellite dishes and antennas
- Removable stairs, decks and railings
- Loose trim or siding
- Utility hoses, cables and connections
Confirm that water, sewer, electrical, gas and other services have been properly disconnected before lifting begins.
Inside the Home
Securing the contents inside the home is a separate preparation job and should be completed before the structure is loaded.
- Remove loose furniture when practical.
- Empty cabinets or secure doors and drawers.
- Remove fragile wall-mounted objects.
- Secure appliances against movement.
- Protect glass fixtures and shower doors.
- Drain plumbing systems where appropriate.
- Secure doors and windows.
- Photograph the interior before transport.
The carrier is responsible for securing the structure to the transport vehicle. FMCSA's cargo securement rules require cargo carried in interstate commerce to be immobilized or secured so it does not shift or fall from the commercial vehicle.
Plan the Delivery Site Before the Truck Leaves
A container home can't simply be delivered to any residential driveway.
Heavy-haul equipment needs enough room to enter, maneuver and leave the property. A crane may need stable ground and sufficient operating clearance. Trees, overhead utility lines, narrow roads, tight corners, soft ground and steep grades can complicate the final approach.
Confirm before shipment:
- The destination can legally receive the structure.
- Required building and zoning approvals are in place.
- The foundation or supports are ready.
- The carrier can physically reach the unloading area.
- Crane access and setup space are available.
- Overhead and lateral clearances have been checked.
- Someone responsible for the property will be present for delivery.
These questions should be answered before the carrier is dispatched. Finding out that a truck or crane can't reach the prepared site after the home arrives can turn a difficult move into a much more expensive one.
Coordinate the Rest of the Property Move
People relocating shipping container homes are rarely moving only the structure. Cars, household belongings, equipment and other property may need to arrive at roughly the same time.
Keeping those moves separate but coordinated can simplify the process. A specialized heavy-haul provider handles the container structure while an auto transport carrier handles vehicles using equipment intended for that job.
This becomes especially useful on interstate relocations. You don't want the container home arriving before the site is accessible while your car or household shipment is scheduled around a completely different timeline.
Start with the structure because its permits, equipment and route restrictions usually give it the least scheduling flexibility. Then build the other parts of the relocation around that window.
FAQs
What specific road permits are required to transport a container home between states?
There is no single federal permit covering the entire trip. Oversize and overweight permits are issued by states, so requirements depend on the dimensions and weight of the loaded vehicle and the states on the route.
A container home may require overwidth, overheight or overweight authorization. States may also impose route, travel-time, escort and other operating requirements. Your carrier should identify the route and secure the necessary permits before transport begins.
How should the interior fixtures be secured to prevent damage during transport?
Anything that can shift, swing, open or vibrate should be removed, locked or physically secured. Pay particular attention to appliances, cabinet doors, drawers, hanging fixtures, glass panels, plumbing fixtures and wall-mounted objects.
Take detailed photos before the move. If the structure contains unusual or particularly valuable built-ins, ask the transporter what preparation it expects before loading.
Does transport insurance cover structural damage to a container home during transit?
Don't assume standard cargo coverage protects every part of a converted container home or every possible cause of loss. Coverage depends on the carrier's policy, the declared nature and value of the load, exclusions and the circumstances surrounding a claim.
Before booking, describe the structure accurately and request proof of the carrier's insurance. Ask specifically whether the policy covers the completed structure, modifications and permanently installed components while it is being transported. If the available limits or terms aren't adequate for the home's value, discuss supplemental coverage before pickup.
Plan the Transport Before You Plan the Moving Day
Moving a container home across state lines starts with measurements, weight, route access and permits, not a pickup date. Those details determine the trailer, loading method and regulatory requirements that make the move possible.
Once the structure's transport plan is established, contact us to coordinate vehicle transport with the rest of your property relocation. With the major transportation pieces identified early, you can schedule your vehicles, household goods and other belongings around the container home's moving window.
